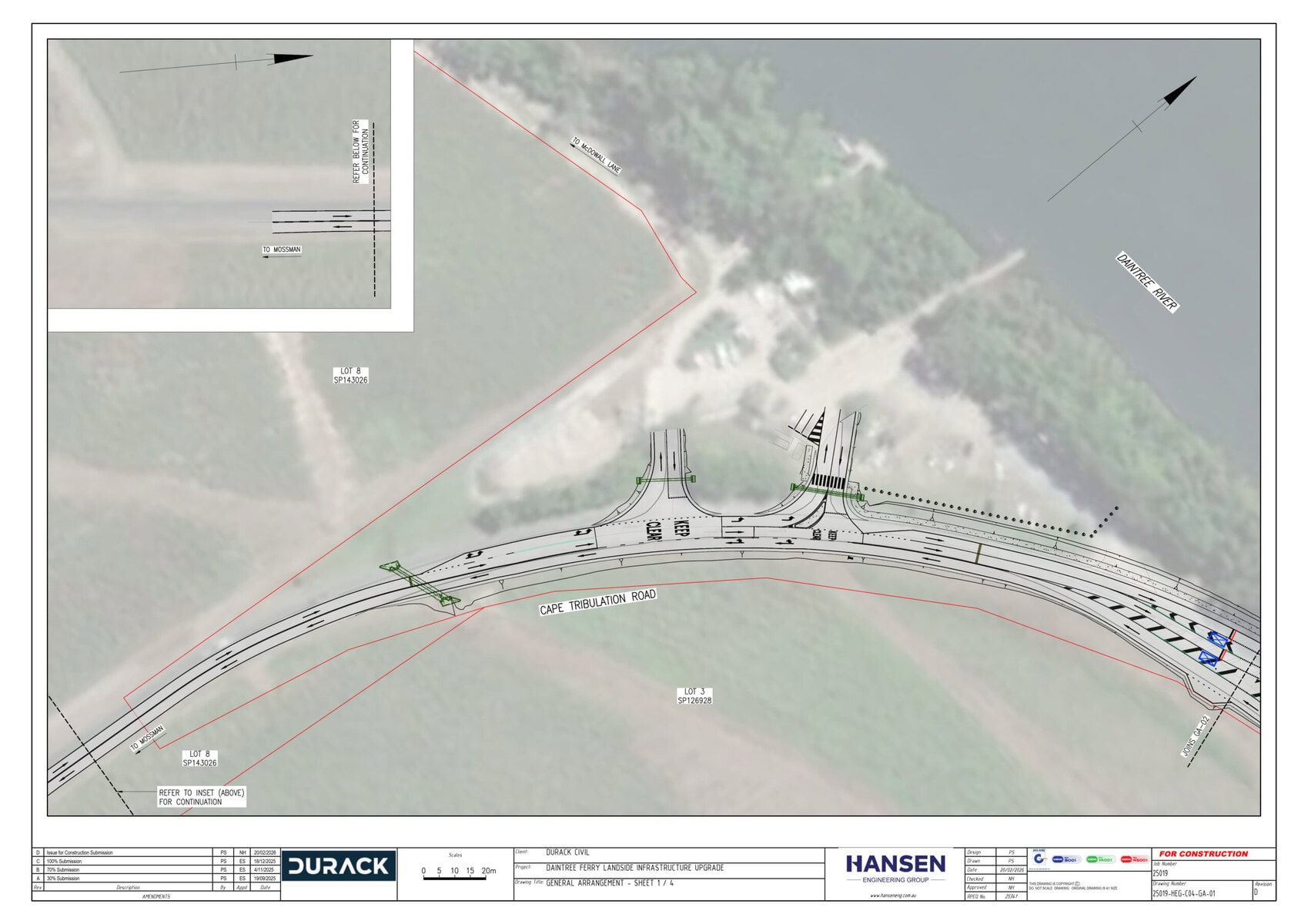

Building a Better Connection

Douglas Shire Council is delivering the Daintree Ferry Upgrade Program—one of the largest infrastructure investments undertaken north of the Daintree River.

The program consists of two major projects:

Landside Infrastructure Project – upgrading the roads, ferry approaches and traffic management on both sides of the river.

New Four-Lane Ferry – replacing the existing ferry with a larger, modern vessel designed to improve capacity, reliability and the overall customer experience.

Together, these projects will improve access for residents, businesses, emergency services and visitors while increasing resilience during severe weather and supporting the long-term future of the Daintree Coast.

Why are these works needed?

The Daintree Ferry is the only road crossing of the Daintree River and is a vital transport link for local communities, tourism, freight, emergency services and school transport.

As demand has grown over many years, the existing ferry approaches and traffic arrangements have become increasingly constrained.

The Daintree Ferry Upgrade Program has been developed to improve safety, reduce congestion, strengthen disaster resilience and provide a more efficient and reliable crossing for decades to come.

Protecting the Daintree Environment

The Daintree Ferry Upgrade Program has been carefully designed to minimise impacts on the surrounding World Heritage environment.

Before construction commenced, extensive environmental assessments, approvals and cultural heritage investigations were completed.

Where vegetation removal has been necessary to safely construct the upgraded infrastructure, rehabilitation and revegetation will form part of the project.

Douglas Shire Council is committed to delivering essential infrastructure while protecting the unique environmental values that make the Daintree one of the world’s most significant natural areas.

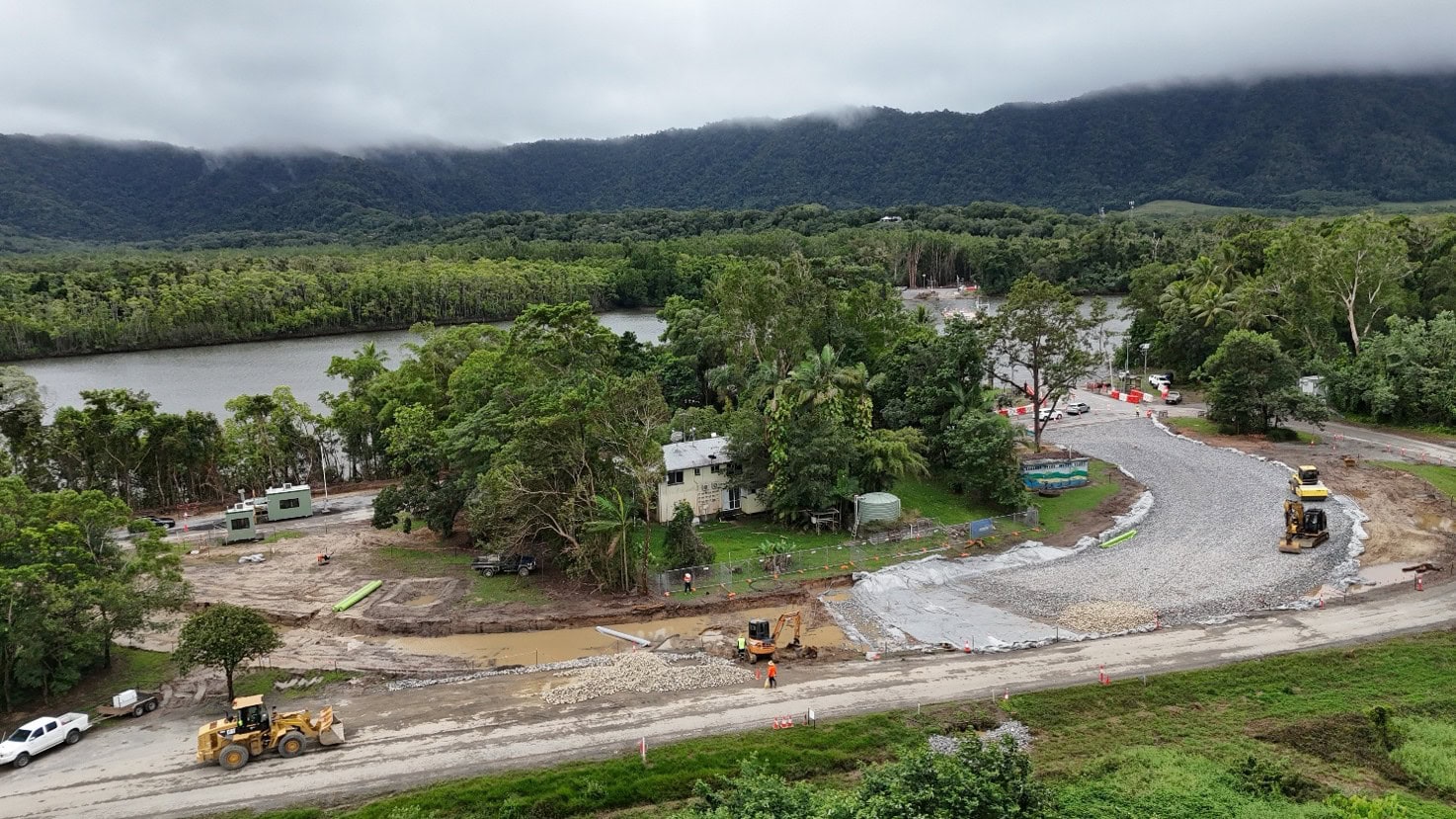

Why is there so much construction?

If you’ve recently visited the ferry precinct, you’ll notice vegetation clearing, earthworks and changes to the traffic layout.

These works are preparing the site for the new ferry approaches, upgraded traffic lanes and supporting infrastructure that will improve the safety, efficiency and resilience of the crossing.

Although the site may look quite different during construction, these works are the first stage of delivering a better ferry service for the future.

Latest Project Updates

Tuesday, 21 July 2026

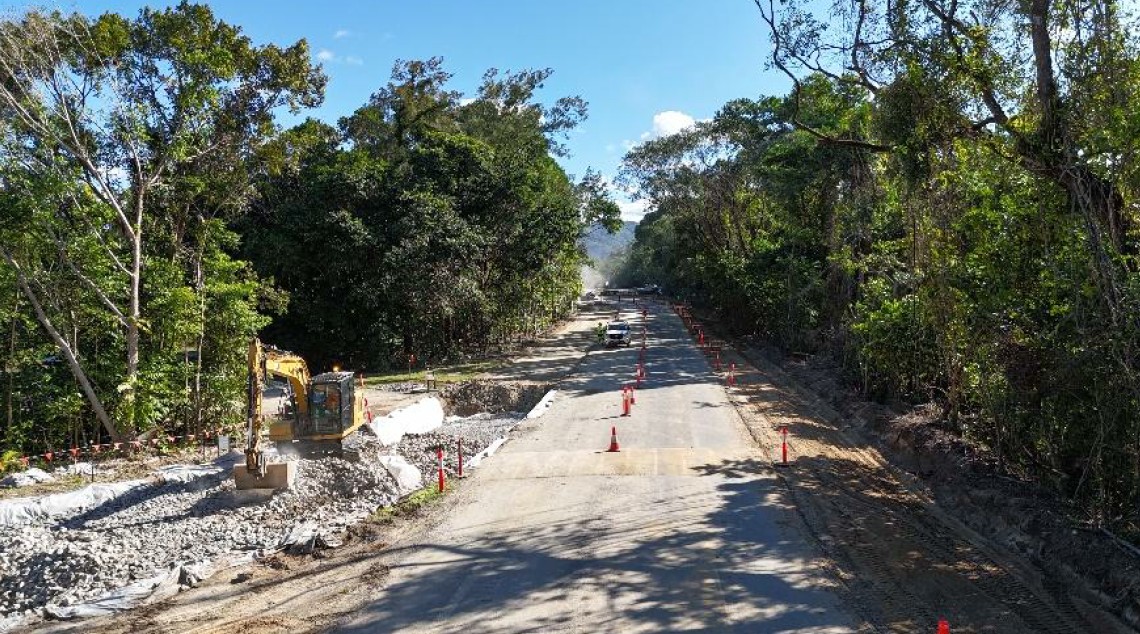

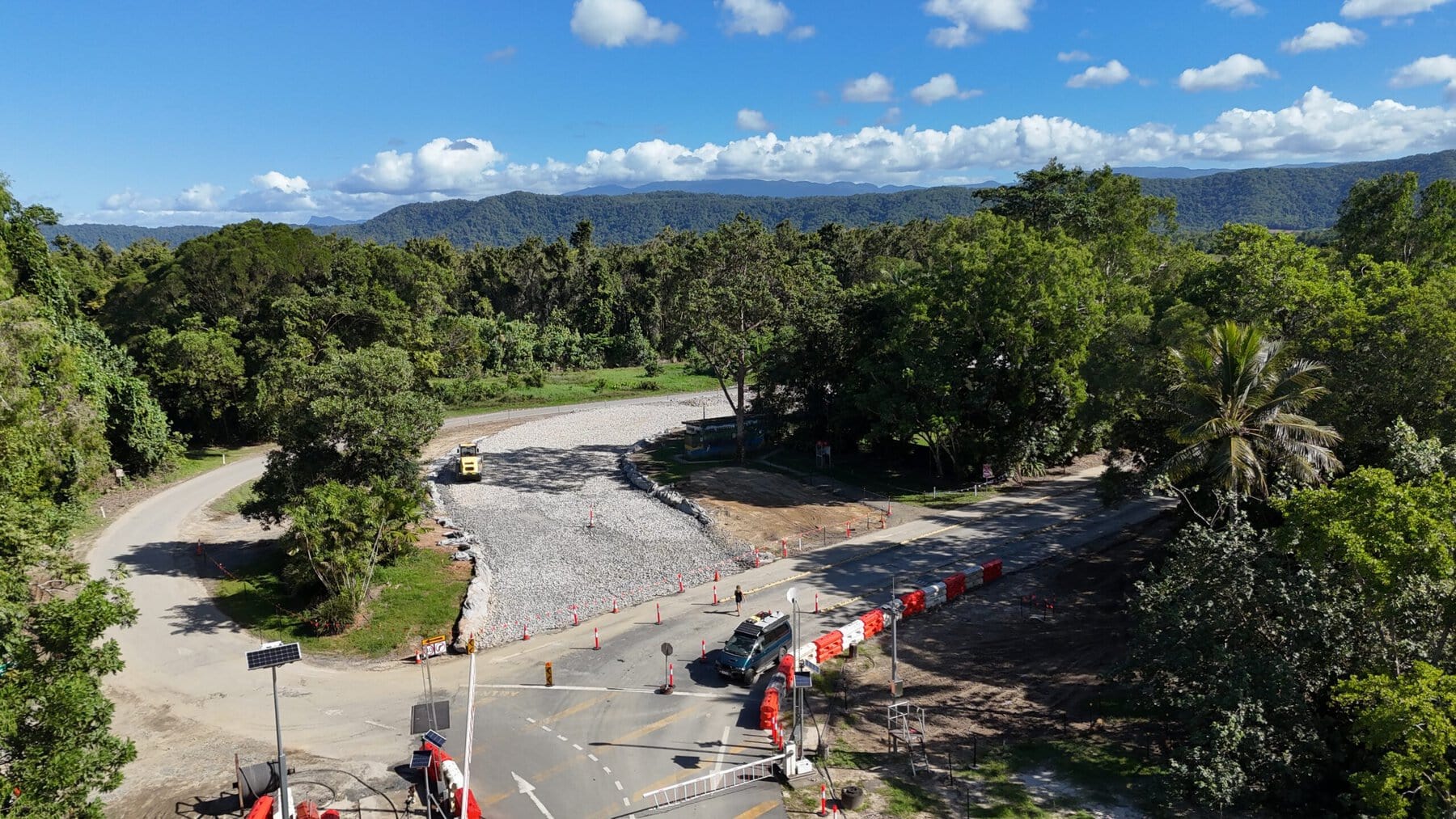

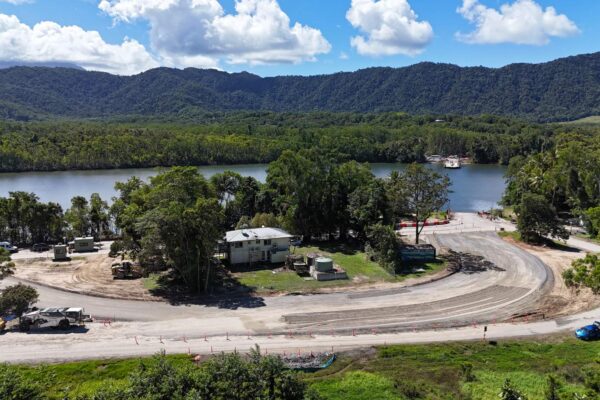

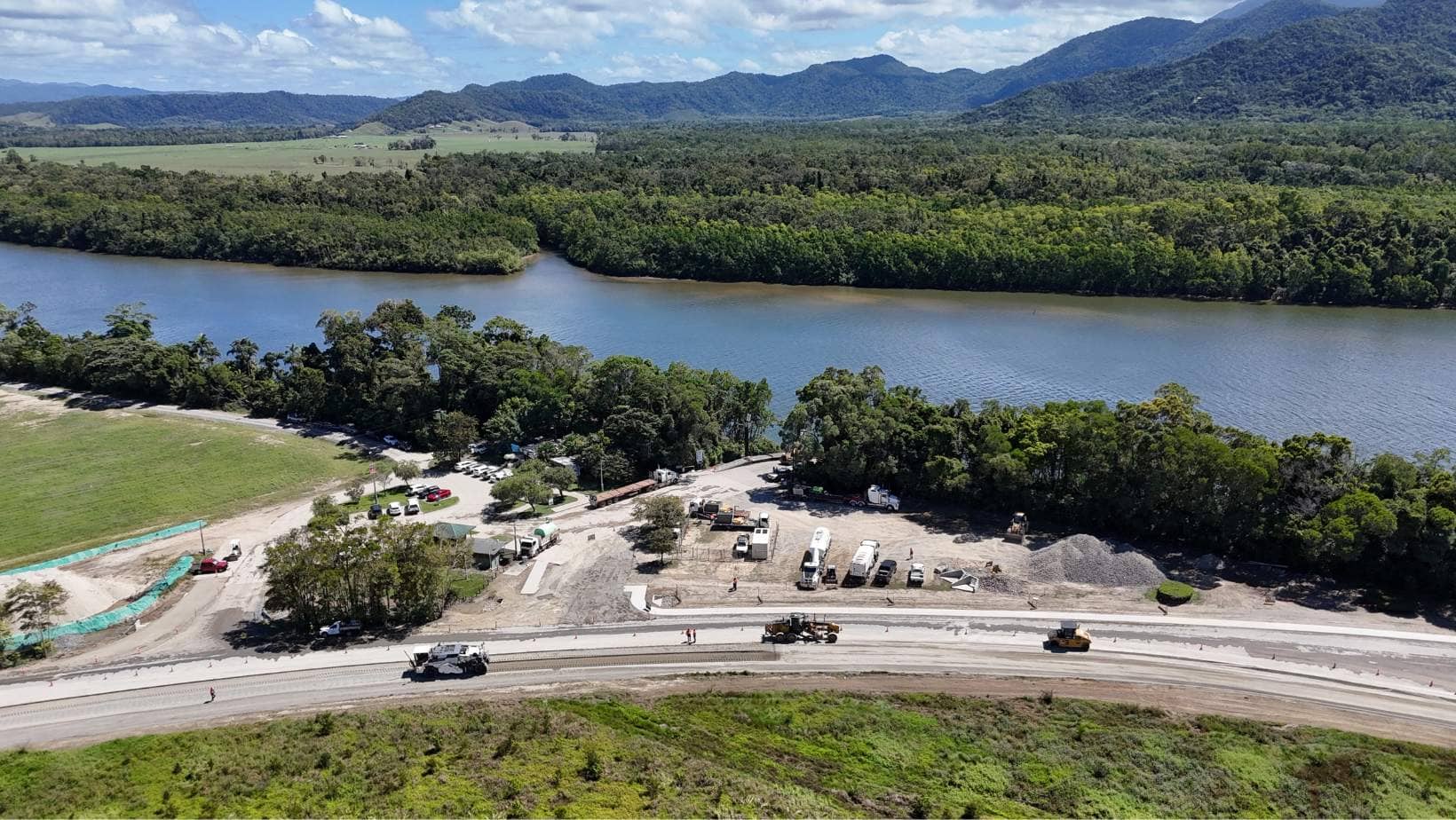

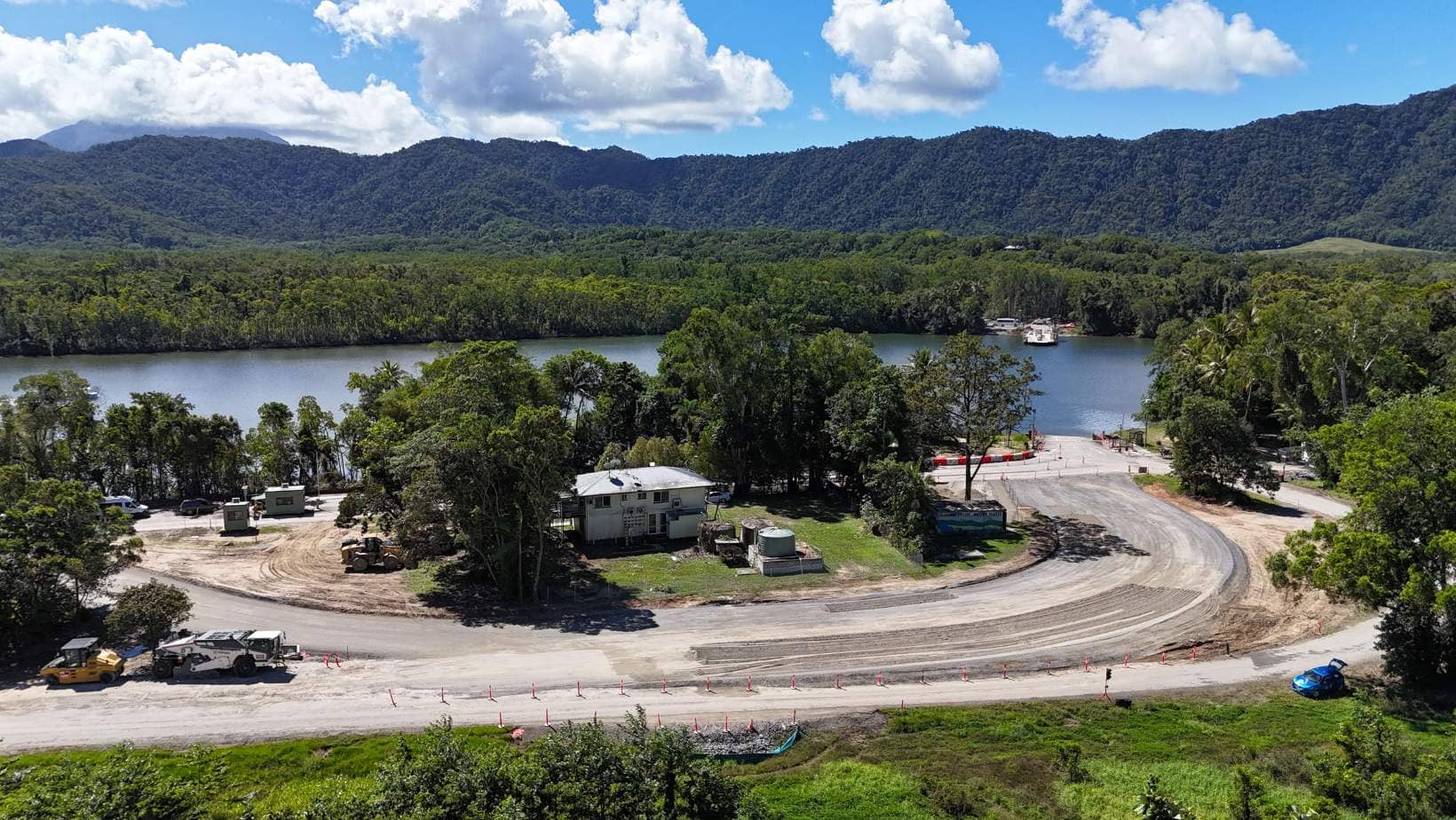

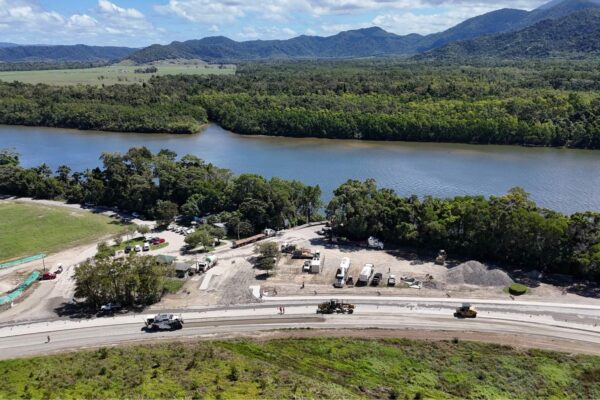

Construction continues to progress on the southern side of the ferry precinct.

This week crews will be:

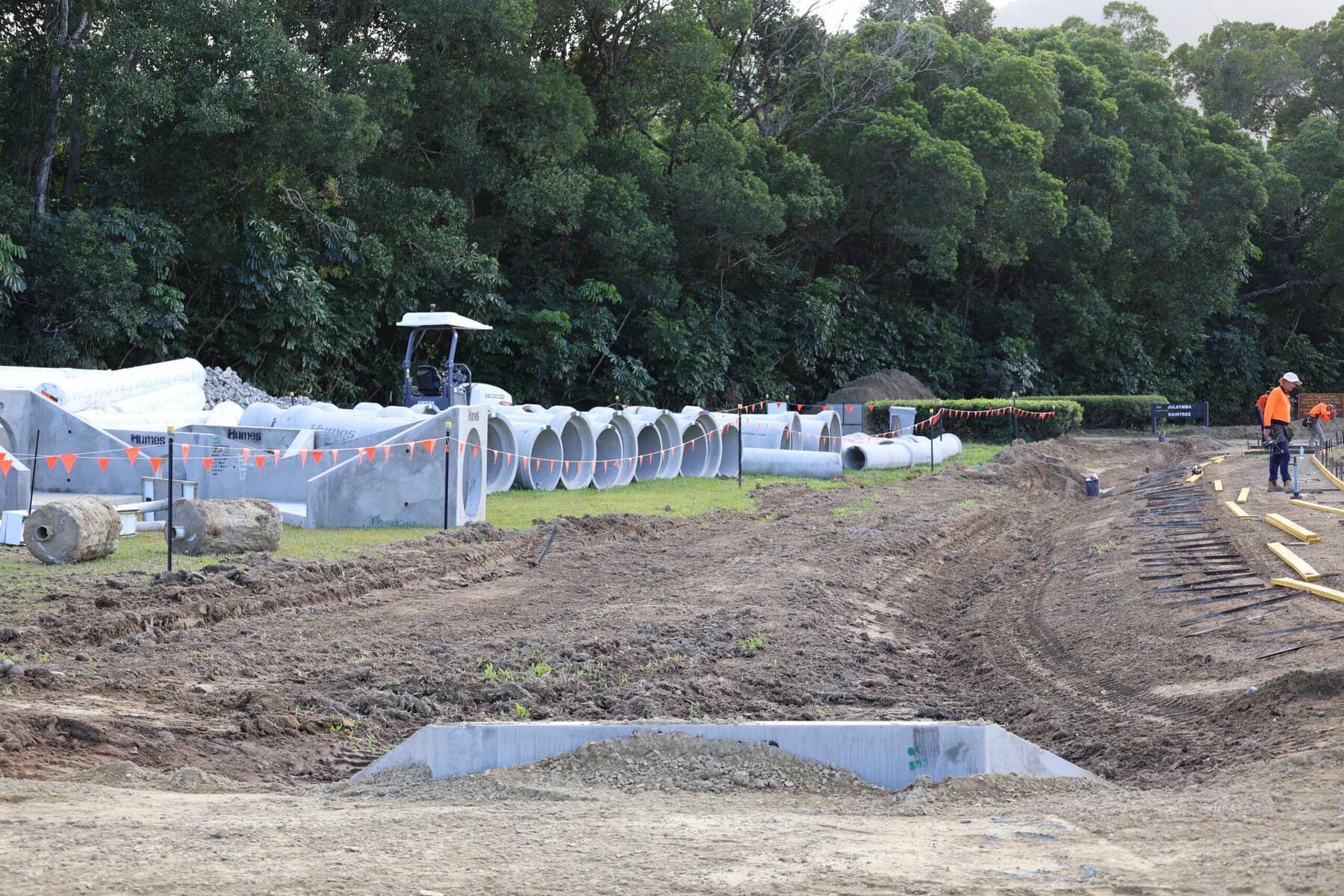

  • Continuing to install new culverts while maintaining traffic flow through the work site.

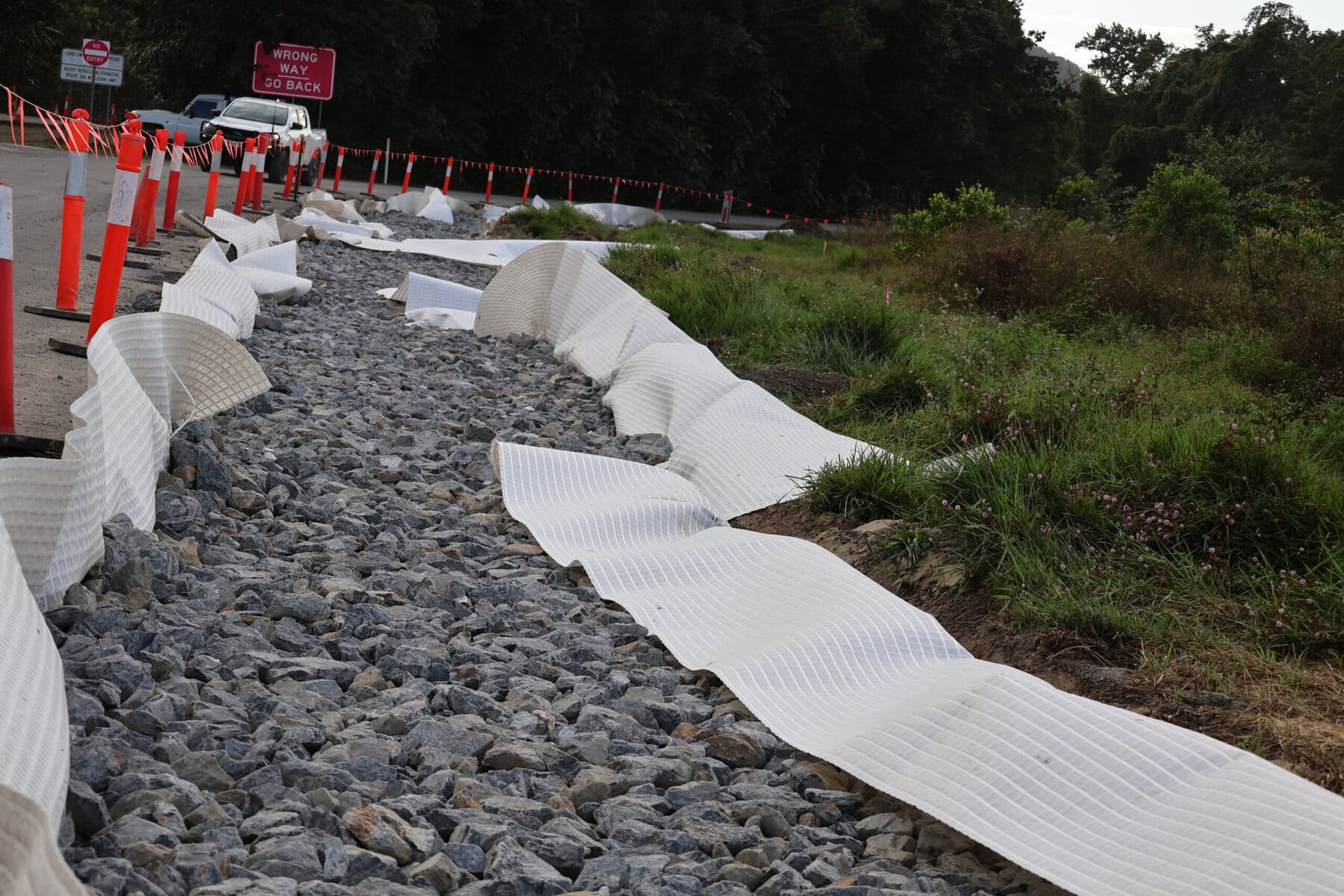

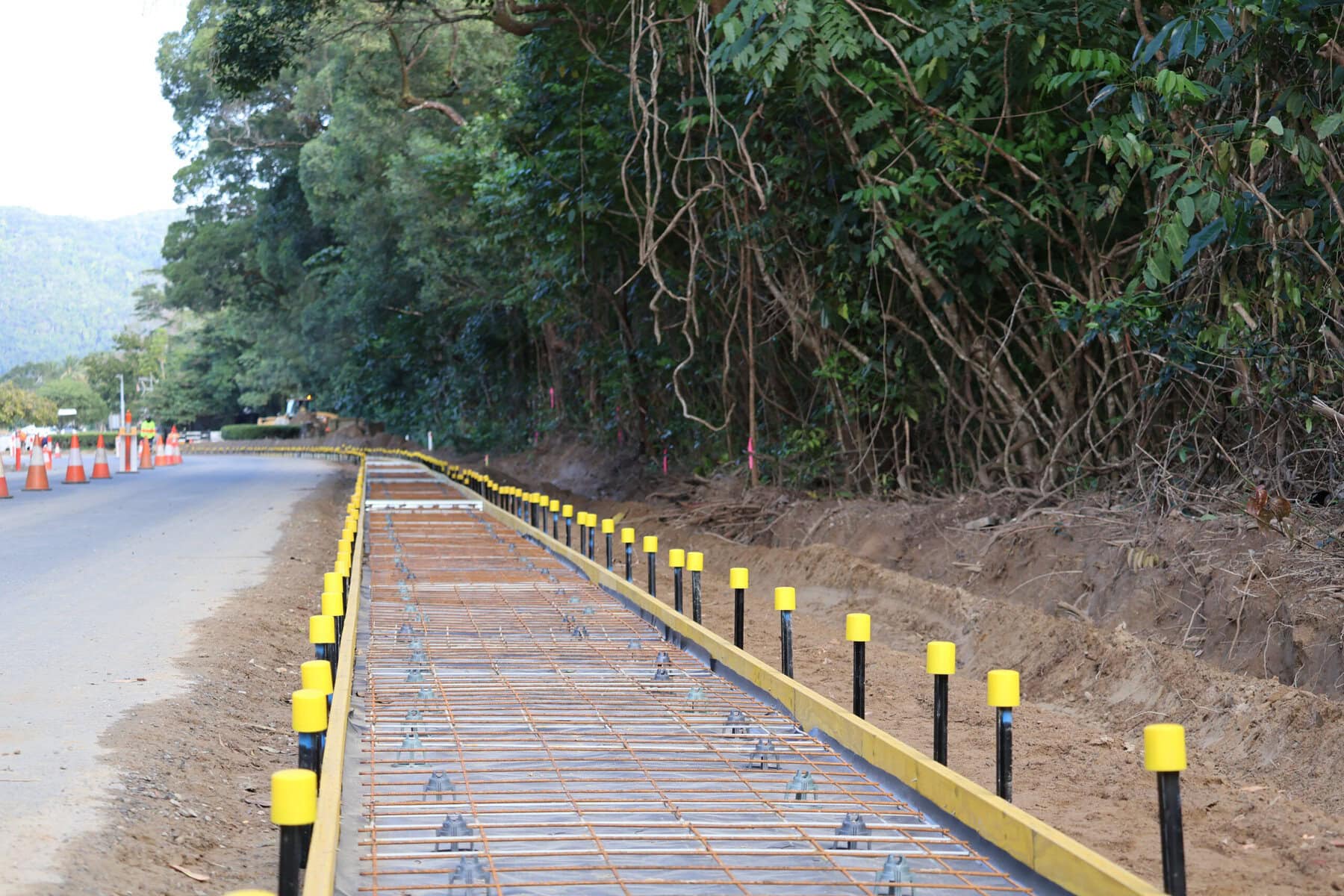

  • Preparing and pouring concrete for new footpaths, both north and south.

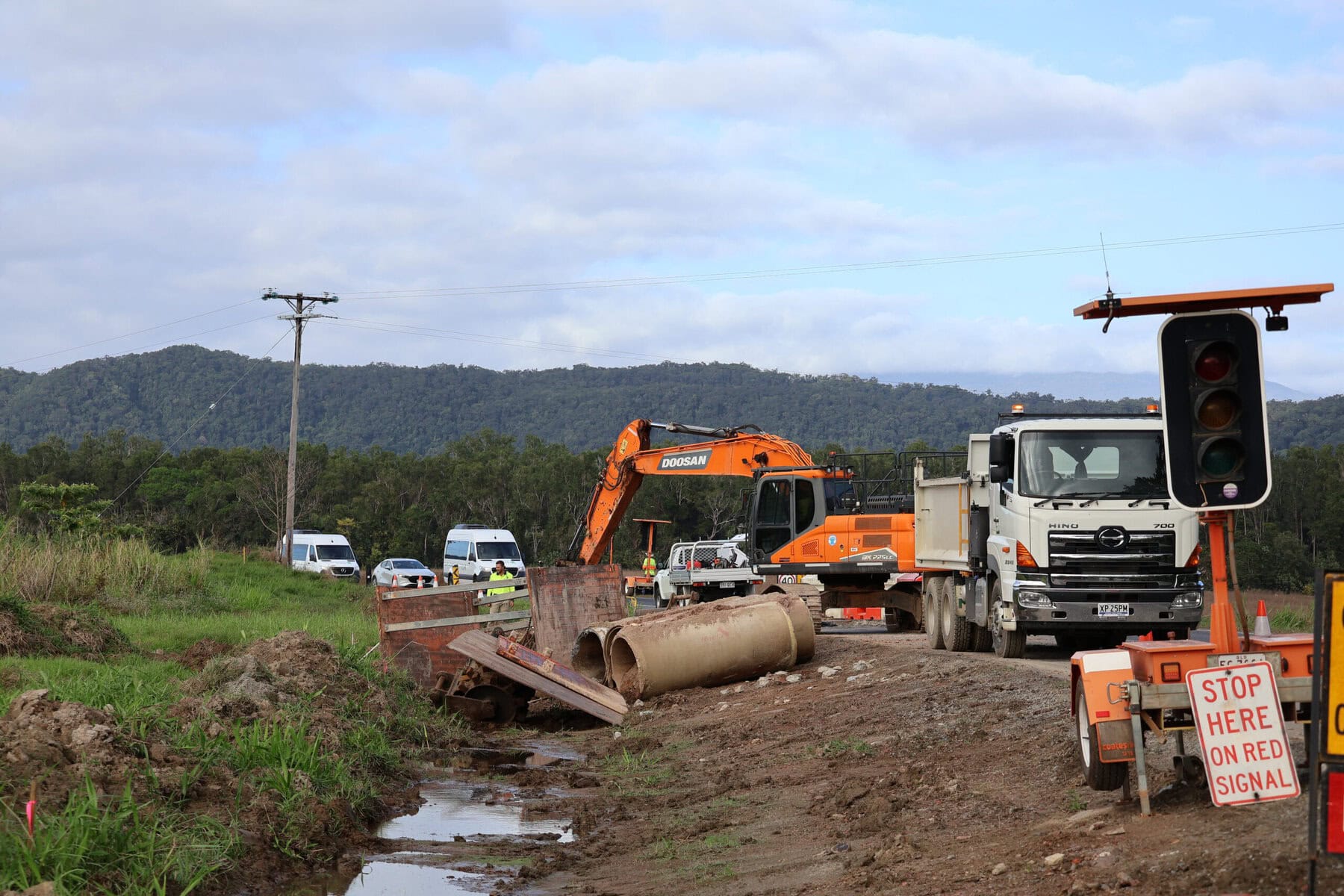

  • Continuing road foundation and earthworks on the southern approach.
  • Undertaking underground electrical works to support the new ticket booth location and future ferry infrastructure.

Contractors are back onsite from today, Tuesday 21 July. The priority lane is now closed while construction resumes. Motorists should continue to expect minor delays while traffic moves through the work area. Thank you for your patience as these important upgrades continue.

Monday 13 July 2026

Work is continuing on the Daintree Ferry Landside Infrastructure Project, with activity taking place on both sides of the river. Here’s what’s happening this week.

  •  Footpath works – Preparation is underway for new footpaths between the boaties’ car park and the ferry landing on the southern side.
  • Earthworks – Rock fill continues to be placed on the southern approach following excavation works. This will continue to affect traffic lanes approaching the ticket booth while construction is underway.
  • Roadworks – Road base is being placed on completed sections of the new road formation on the southern side.
  • Electrical works – Underground electrical and communications works continue on the southern side, including:
    • relocating power and communications to the future ticket booth location;
    • installing fibre optic cabling conduits between the ferry house and the new ticket booth;
    • providing power to the southern ferry landing for new floodlighting, boom gates and associated infrastructure.

Every effort is being made to minimise disruption while these important upgrades are completed. We appreciate your patience as work continues to improve the safety, efficiency and resilience of the Daintree Ferry precinct.

Friday 10 July 2026

Construction of the Daintree Ferry Landside Infrastructure Project is continuing, and while every effort is being made to minimise impacts, some delays are unavoidable during this stage of the works.

To help keep traffic moving as efficiently as possible:

  • The ferry operator is facilitating priority loading for local residents and tour operators where possible, within the constraints of the current site.
  • Council staff continue to monitor ferry operations and work with the contractor and ferry operator to identify opportunities to improve loading and unloading efficiency.

The southern priority lane is expected to reopen in approximately one month’s time, subject to weather, construction progress and traffic volumes.

We appreciate the community’s patience while these important upgrades are completed. The project will deliver improved traffic flow, safer access and a more efficient ferry precinct for residents, businesses and visitors.

Please continue to follow all traffic management signage and the directions of traffic controllers when travelling through the area.

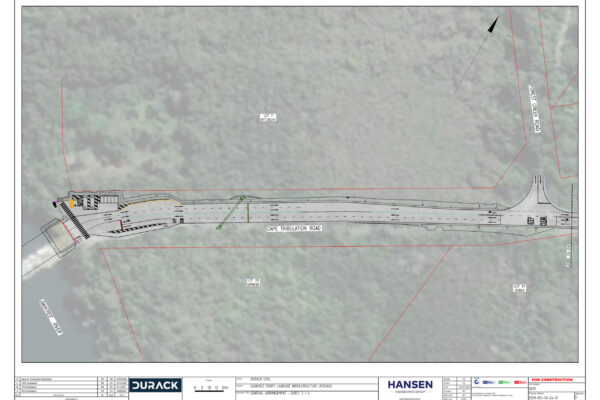

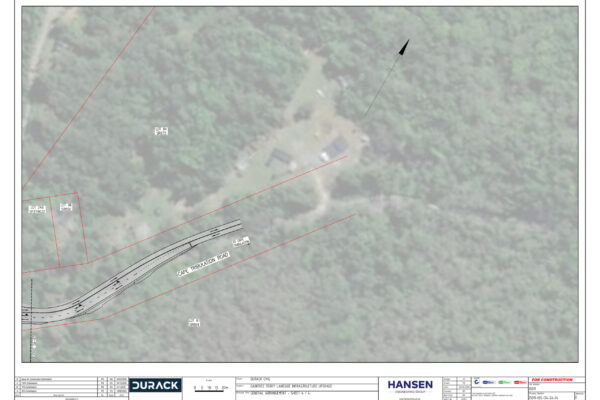

Indicative Timeline – Landside Infrastructure

February – June 2026

  • Planning complete and construction commenced, including design approvals, cultural heritage agreements, contractor mobilisation, vegetation clearing and establishment of traffic management.

July – August 2026

  • Subgrade excavations
  • Installation of larger culverts
  • Embankment fill and ground treatments

September – October 2026

  • Electrical conduits and underground services
  • Road primer and sealing works
  • Reseal of existing road
  • Line marking, speed humps and signage
  • Installation of boom gates and curtain gates

Mid-October 2026 – June 2027

  • Demobilisation
  • Works pause until maritime civil works commence mid-2027

Community Reference Group

Douglas Shire Council established the Daintree Coast Community Reference Group to provide two-way communication throughout delivery of the project.

The group includes residents, businesses and community representatives and receives regular updates on:

  • Road recovery projects
  • Ferry Upgrade Program
  • Disaster recovery initiatives
  • Community access issues

Meeting notes and newsletters can be viewed here.

[Link to Daintree Coast Updates page]

Landside Infrastructure Construction Gallery

See how construction is progressing.

Ferry Build Gallery

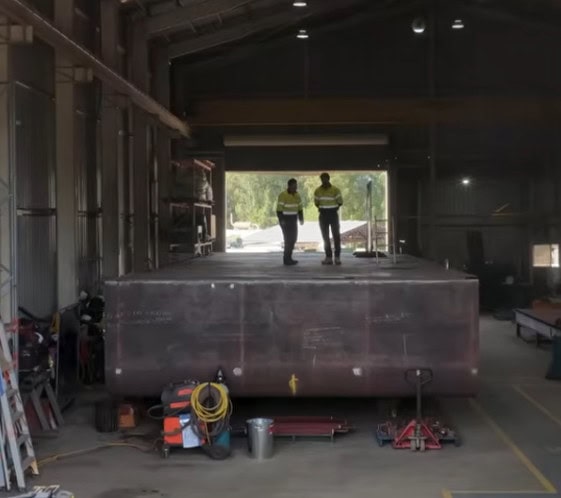

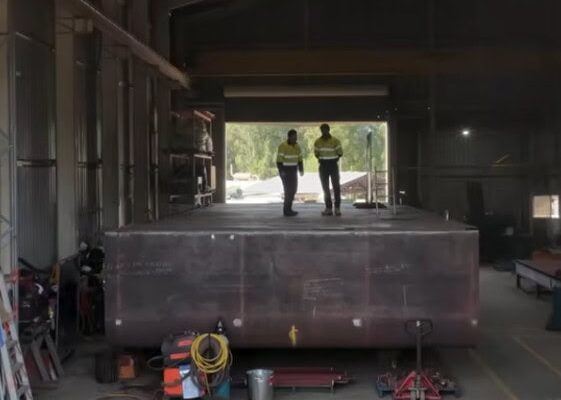

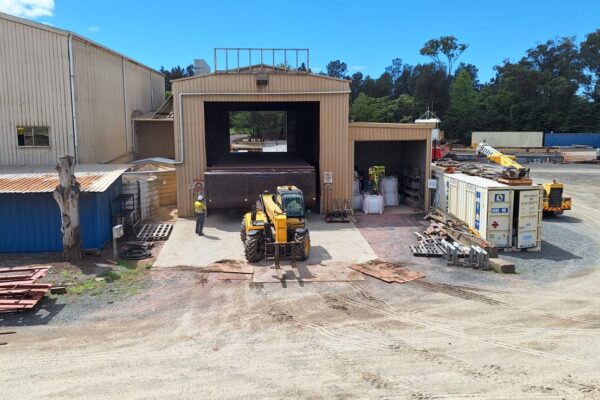

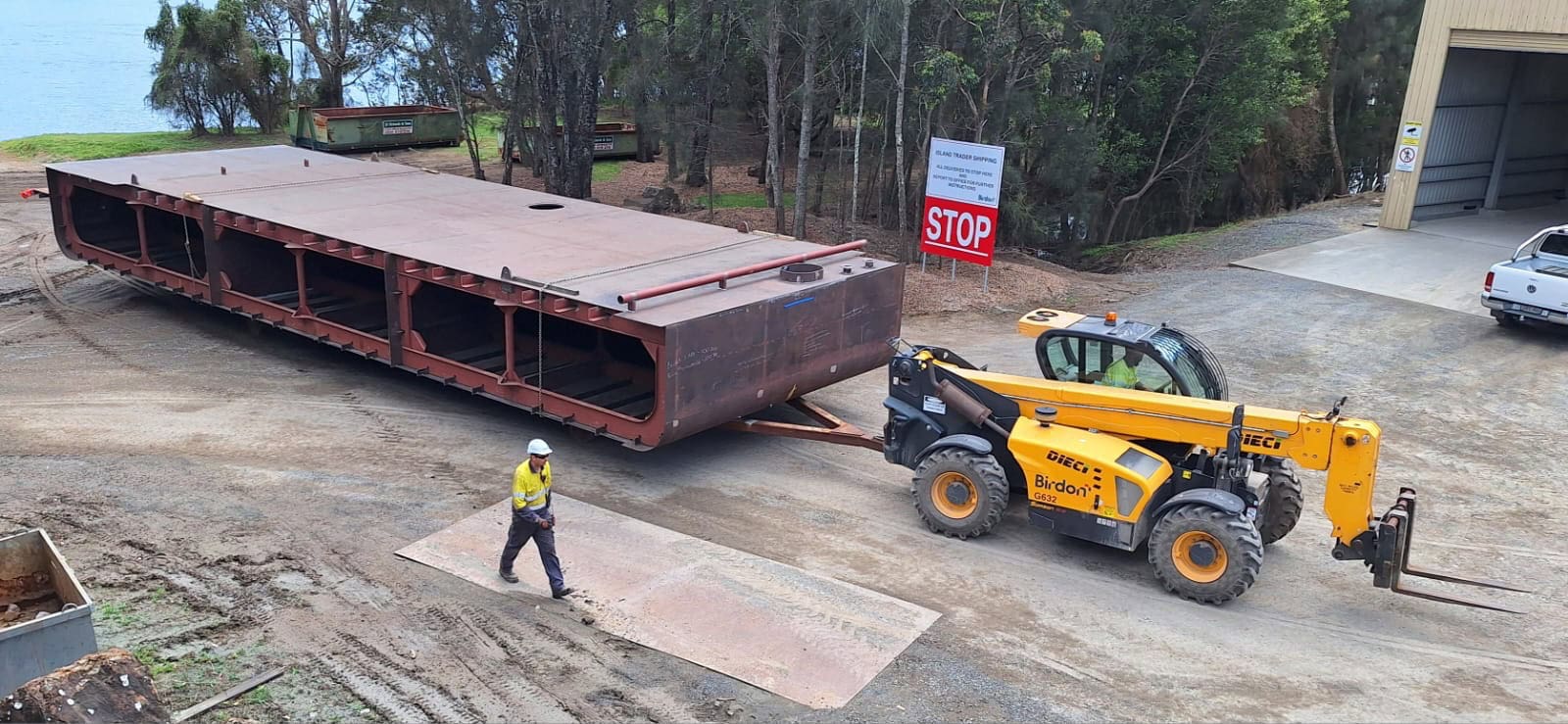

See how the progress of the ferry from concept through to construction is progressing.

Concept Plans

Concept Design Gallery: Use the arrow below to change image

Public Information Session Recordings – 20 November 2025
Douglas Shire Council Project Overview

Durack Civil (Landside Infrastructure)

Birdon Pty Ltd (Ferry Replacement and Operation)

Questions (see FAQ section below for full list of questions)

Media Releases and Community Updates
Council Meeting Reports

Frequently Asked Questions

Council is upgrading the roads and ferry ramps on both sides of the Daintree River to prepare for a new, higher-capacity ferry. These works will reduce wait times, improve traffic flow, and support local residents, services, tourism, and school travel.

Extensive community engagement and traffic modelling were carried out across several stages. Of the 3,409 survey responses, 66% preferred an improved ferry service while 33% preferred a bridge. The outcome showed that a larger, dual-loading ferry with landside upgrades was the most practical and widely supported option.

Landside works will start after the 2026 wet season (expected May 2026), with the ferry ramp replacement and new ferry commissioning planned for late 2027.

Yes. The ferry will continue to operate throughout the project, except during a planned closure period of approximately 10-14 days in late 2027 for concrete ramp removals and reconstruction of larger concrete ramps and ferry commissioning.

The vehicle ferry service will be offline for a minimum of 10 days. This timeframe includes ramp removal, pylon checks, new ramp installation, ferry positioning, and river trials. Engineering efficiencies have significantly reduced what would have been a potential 40-day closure.

Yes. A free pedestrian ferry will run continuously during daylight hours. Council will also provide shuttle services to and from designated car parks on both sides of the river, with managed parking to support both locals and visitors.  Parking and shuttle locations will be confirmed closer to the closure period.

The new ferry will have dual loading and unloading lanes, reducing queuing times. It will also support a new priority lane system on both the south and north side of the river for locals and concession card holders and improved traffic management for tourism vehicles and services.

South side: New lanes, relocated ticket booths, and better queuing for all vehicles.

North side: New priority lanes, extended disembark areas, and a designated bus collection zone.

No. Under Queensland law, Council cannot make a profit from ferry fees. All funds from ticket sales must be used to operate and improve the ferry service and associated infrastructure.

Council reviews pricing annually in line with CPI and operating costs. Any changes are part of this regular review process and must reflect service delivery costs.

Yes. The new ferry and service have been modelled over a 20-year period, factoring in projected usage, CPI increases, and minor ticket pricing adjustments. This modelling indicates the service will be sustainable over the long term.

Yes. A small number of trees will be removed for the south approach road realignment and on the northern approach to create a locals’ priority lane. No trees will be removed for the new ramps, which will be in the same location as the existing ones.

No. The ferry will continue to operate in the same location, and no mangroves or other marine plants will be disturbed during the ramp works or ferry replacement.

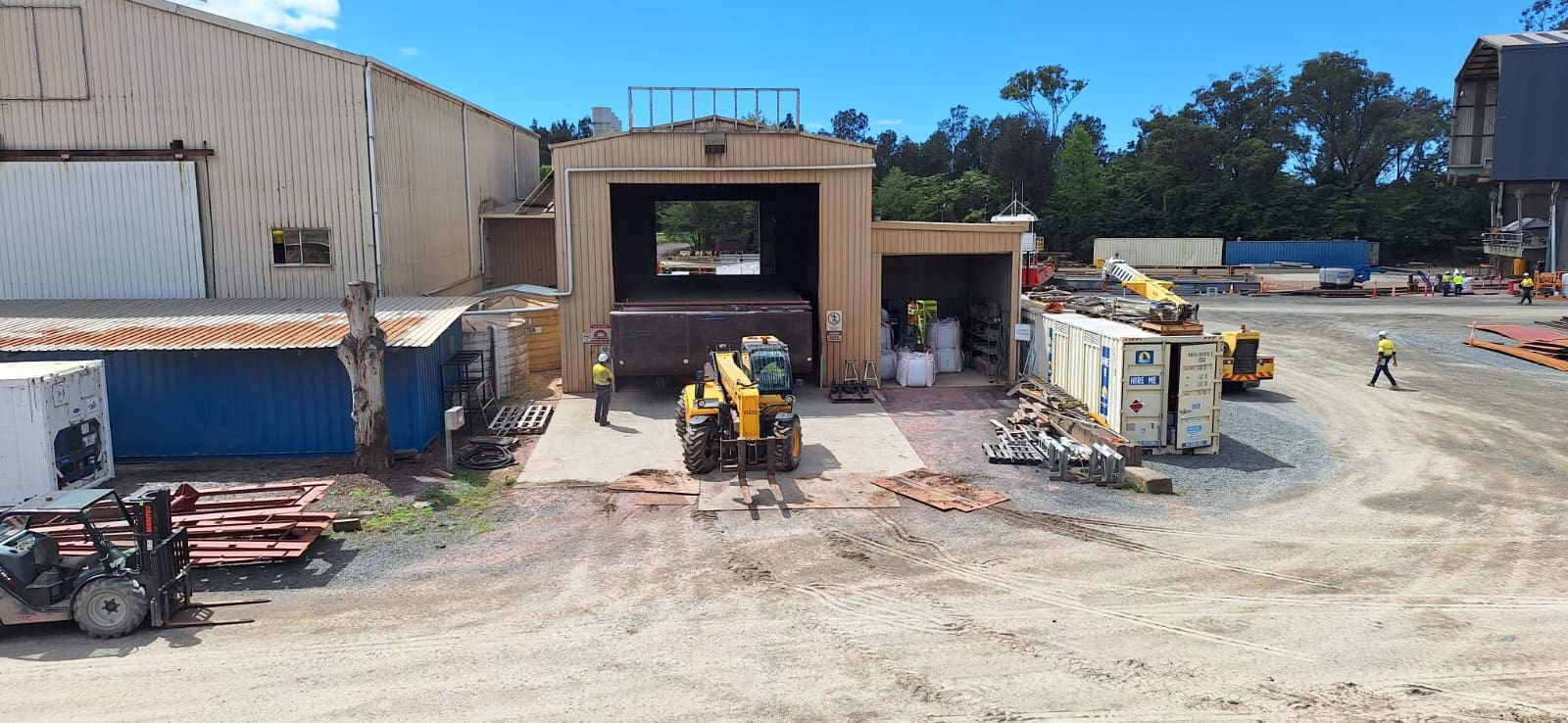

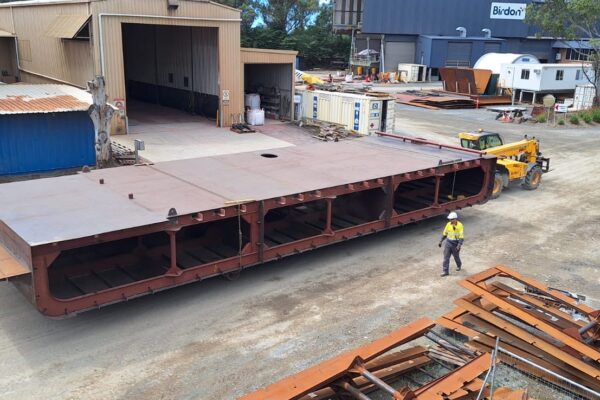

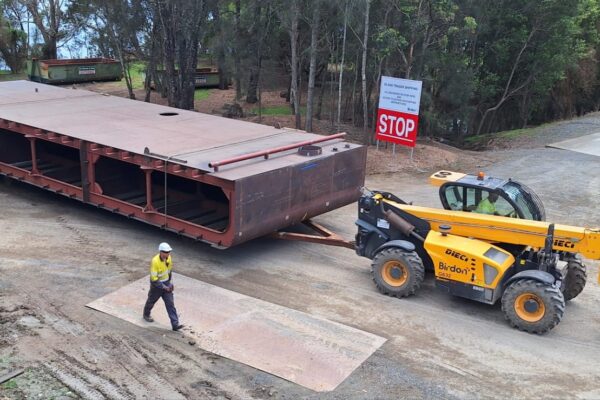

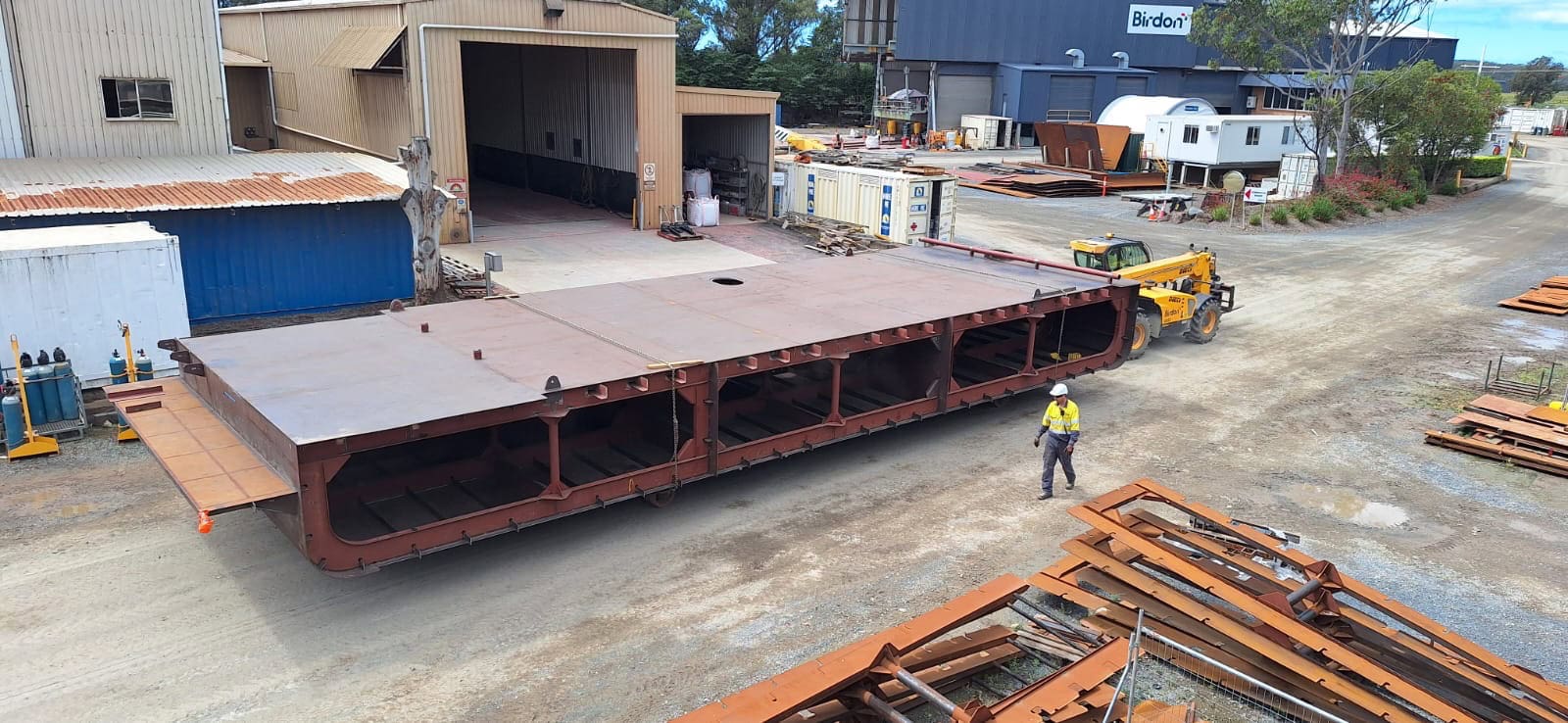

The new ferry is being designed and built by Birdon Pty Ltd in Port Macquarie, with construction expected to take up to two years. It will then be towed to the Daintree River over seven days (weather permitting), with delivery scheduled by the end of 2027.

Yes. Community updates and engagement are a priority. A Daintree Ferry Landside Infrastructure Reference Group is being formed, and Council will share progress updates, timelines, and closure dates well in advance. A full communication program will support locals and businesses throughout.

No. Existing car parking at the boat ramp will be retained as part of the project.

Priority lanes will operate on both sides of the river and will be clearly identified through signage and road markings. Lane markings will comply with road regulations and include additional guidance to help all drivers, including visitors, use the correct lanes safely.

The design includes traffic calming, improved entry and exit points, bus parking and lane configuration to address long-standing safety and congestion concerns.  Bus movements and turning areas are being reviewed as part of the design to improve safety and traffic flow on the northern side.

When roads are flooded, access to the ferry is not possible. The new works improve efficiency in normal conditions but do not change flood constraints.  The ferry does not operate during extreme weather events and flooding.

Safety will always come first. The ferry must be secured during daylight hours before river conditions deteriorate. Early communication will continue, and residents are encouraged to activate their own cyclone plans early.

The ferry will continue to operate on the same scheduled days as the current service, excluding emergency events.

AMSA surveys are required every five years. While some pre-survey work will occur in water, the ferry must be hauled out to meet regulatory requirements.  The ferry will be offline for approximately 14 days to complete the mandatory survey.

The first survey will be schedule 5 years from the date of commencement of the new ferry (around 2032). Surveys can be scheduled up to two years in advance, allowing at least 24 months’ notice where possible.

Designs will be shared after regulatory approval, noting some drawings may not be released due to intellectual property considerations.

No significant increase in dredging is required. Although the new ferry is wider and heavier, it will have a similar draft to the existing ferry, so additional weight does not automatically mean deeper dredging is needed.  Some initial dredging will be required to accommodate the wider vessel.  All required approvals are being progressed through the State Assessment and Referral Agency in consultation with relevant State Government agencies.

All dredging works are managed in accordance with State approvals and will continue to be overseen by Council operations staff in accordance with conditions.

The new ferry includes acoustic insulation and modern engines, which are typically quieter. PA announcements are mandated for safety but will be reviewed and minimised where possible.

The ferry does not have independent propulsion.  The movement of the vessel if a cable breaks will depend if it’s the cable on the drive wheel side.

Ramp design accounts for maximum loading requirements and dual loading/unloading operations.

Up to 189 vehicles can queue beyond the ticket booths. With a 36-vehicle ferry, ticketing will not delay loading.

No ticket booth is planned, but spare conduit is being installed for future flexibility.

A full closure of approximately 10–14 days is expected. Both ramps will be replaced at the same time, with passenger ferry and shuttle services provided throughout the closure.

The new ferry will be pre-positioned before ramp works begin. Existing ramps will not be removed until the ferry arrives.

Nightly inspections, locally sourced and stored spare parts and Birdon’s backup shipyards will reduce the risk of breakdowns.

Birdon is developing a communications plan including website, email, SMS and other tools for areas with limited coverage.

Staff shelter and heat protection are being incorporated into the ferry design.

Works will generally occur under single-lane closures with traffic management. Limited night works may be considered if noise impacts can be managed.

Traffic modelling assumes approximately 1% annual growth supported by the upgraded ferry and infrastructure.

Contractual revenue arrangements are commercial in confidence.

Ferry revenue is managed through Council’s consolidated revenue and considered as part of annual budget processes.

  • Project updates on Council’s web page
  • Direct emails and SMS
  • Social media updates
  • Reference Group discussions and community meetings and drop-in sessions
  • Signage on site and along ferry approaches

How Can I Stay Informed?

There are several ways to keep up to date:

  • Project updates on this page
  • Keep up to date with the Daintree Coast Community Update page
    • Here you can read the meeting notes for the Daintree Coast Community Reference Group
    • Subscribe to the Daintree Coast Community Updates newsletter
    • Subscribe to SMS alerts – for urgent access messages (road closures, unplanned interruptions to ferry service, etc)
  • Douglas Shire Council social media
  • Works notices (sent to the Daintree Coast Community updates subscribers

Have a Question?

Douglas Shire Council is committed to keeping the community informed throughout construction.

If you have a question, suggestion or feedback about the project, we’d love to hear from you.

📞 (07) 4099 9444

✉ enquiries@douglas.qld.gov.au

Ferry Statistics

Council has been collecting data on the usage of the Daintree Ferry since 2004. Below you’ll find graphs depicting total annual ticket sales of one-way and return traffic for the two most popular vehicle types using the ferry.

Council also records data for a variety of other vehicle types, concessional travel and multi-day tickets.

Latest monthly statistics available here
